Deadhorse airport upgrade will fill nearly 79 acres of wetlands with no mitigation
A construction package underway at Deadhorse Airport — the aviation gateway for North Slope oil, gas and pipeline workers — will fill 78.6 acres of wetlands and other federally regulated waters, and the state has proposed no compensatory mitigation for the loss.
In its water quality certification application, the Alaska Department of Transportation and Public Facilities said it planned no mitigation for the filled wetlands, citing the absence of mitigation banks or in-lieu-fee programs in the area. The project places roughly 722,700 cubic yards of gravel and builds a 20,000-foot wildlife perimeter fence around the airfield.
The work is aimed at safety, drainage and wildlife-conflict problems: it fills infield ponds next to the runway and apron, replaces failing culverts, improves drainage along Deadhorse Drive, and adds the perimeter fence and a service road. The Federal Aviation Administration issued a finding of no significant impact in 2023 and funds the work through the Airport Improvement Program.
Construction is progressing through the short Arctic building season, with paving and culvert work underway and infield areas being filled. Project records list conflicting completion targets — the environmental document anticipated work running into fall 2026, while the bid notice sets a completion date of Oct. 31, 2027.
What did you make of this story? (no account needed)
Made by our human newsroom with AI. How humans and AI work here · Grow with our newsroom ·
Keep Alaska News free for everyone.
No paywall, ever. Members pay so everyone can read the meetings and records Alaska News covers.
Get Alaska News in your inbox
Create your free account and get the day’s top stories around 6 each morning, in a few minutes’ read.
Top stories, around 6 each morning.
Stories on what you follow, on Sundays.
Based on a press release from Alaska Department of Transportation and Public Facilities.
Earlier in this story
Deadhorse Airport paving set for mid-July after holiday pause

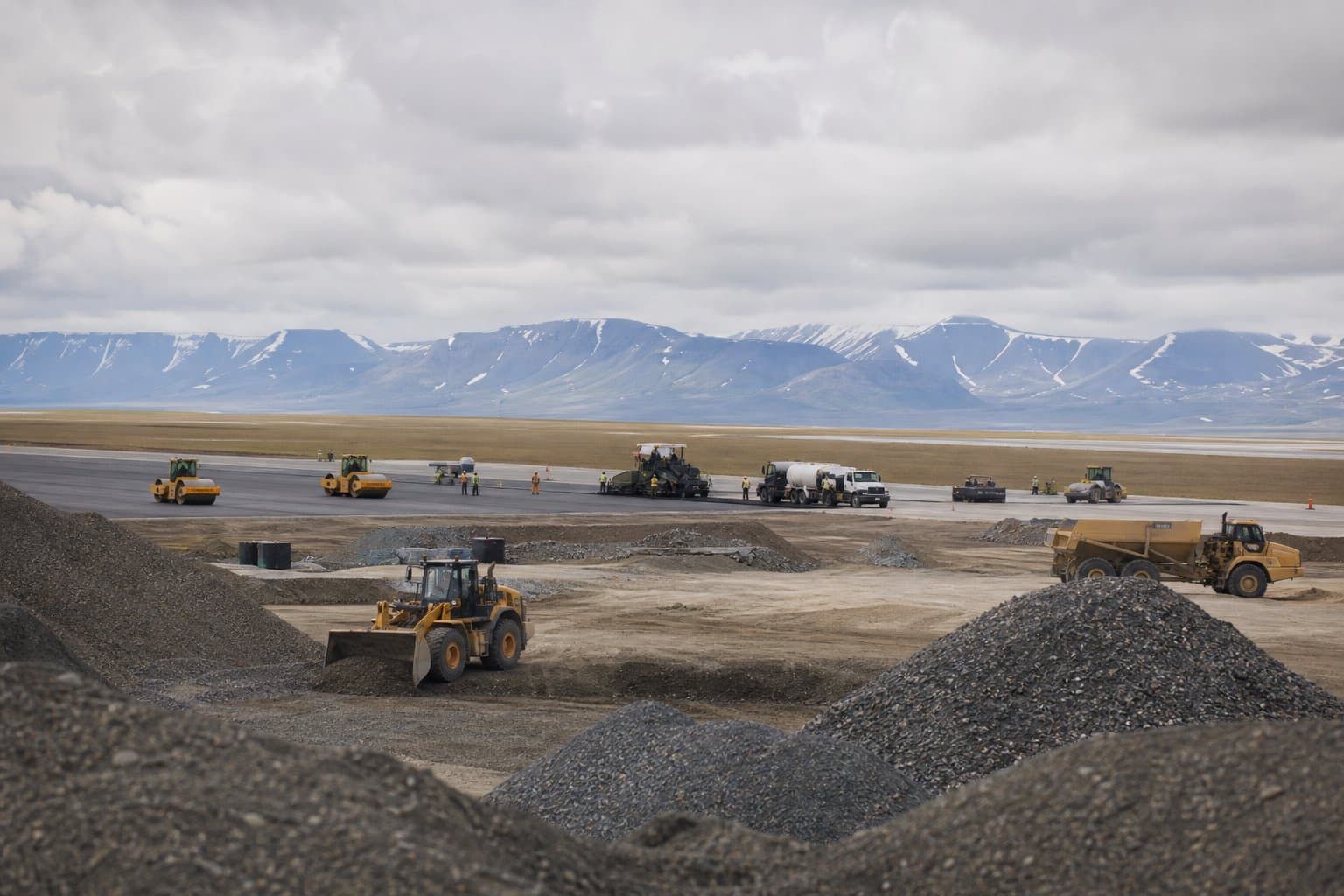

The contractor at Deadhorse Airport has first paving operations tentatively scheduled for mid-July, a step forward in a multi-year improvement project supporting air access to the North Slope.
First paving will cover the temporary Alaska Airlines taxiway and culvert patching on Taxiways A and B. The contractor observed a four-day work stoppage for the Fourth of July holiday before resuming, leaving roughly two weeks to reach that threshold.
Work Underway Before First Paving
Leading up to that milestone, crews have been hauling borrow material from a state Department of Natural Resources pit to Infield 3A1 and installing culverts, pipe end grates, and thaw pipes. The project scope extends beyond pavement. A wildlife perimeter fence with a service road around the airfield is part of the work, addressing a safety concern specific to Arctic airfields where large animals can enter active movement areas. Drainage improvements also extend along Deadhorse Drive, and fill work is ongoing in fields adjacent to the runway and apron.
What the Project Is Meant to Fix
Alaska DOT&PF describes the project's purpose plainly: "The purpose of this project is to remedy Deadhorse Airport deficiencies, address safety concerns, improve drainage, and help bring the airport into compliance with current FAA design standards and criteria." A draft Deadhorse Airport Master Plan released in 2024 identified persistent centerline pavement cracking and aging culverts, recommending resurfacing or reconstruction of airfield pavements by 2027. Construction began in 2025 and is expected to run into 2026.
Stakes for North Slope Workers and Operators
For North Slope workers and contractors, reliable air access through Deadhorse is essential for worker rotations and support of oil and gas operations. Airport planning documents note that construction phasing and possible weather delays could affect flight availability during active work periods.
First paving remains tentatively scheduled for mid-July, contingent on progress through the short Arctic construction season.
Deadhorse Airport project halted by weather, nears drainage milestone
Crews remaking Deadhorse Airport's drainage system, runway aprons, and perimeter fencing will spend May 29 to June 4 idled by weather, the Alaska Department of Transportation and Public Facilities said Monday. The contractor is wrapping up insulation board placement, the layer that slows heat transfer from new pavement into the permafrost below, before fill work continues.
The pause is routine for the North Slope, where the construction window is short even in a good year. What's not routine is the scope of what's being rebuilt. The project, started in 2025 and slated to run into 2026, includes drainage improvements at the airport and along Deadhorse Drive (meltwater pooling over permafrost is one of the more persistent threats to Arctic pavement), along with new fill around the runway and apron, and a wildlife perimeter fence with a service road circling the airfield. Bird strikes and the occasional caribou are real aviation hazards on the tundra.
Deadhorse Airport is the air bridge for Prudhoe Bay, moving the workers, equipment, and cargo that keep the oil fields running. DOT&PF says the project is meant to resolve safety and compliance issues the agency has not publicly enumerated. The state's Northern Region is managing the work in partnership with the Federal Aviation Administration. As of mid-May, crews had installed about 3,500 feet of the wildlife fence.
