Speaker A
120:41 - 121:13
"is phase one financeable on a standalone basis? If costs are not fully recovered by phase one customers, and that again relates to the economics for the project really being driven by that export capacity"
“is phase one financeable on a standalone basis? If costs are not fully recovered by phase one customers, and that again relates to the economics for the project really being driven by that export capacity”

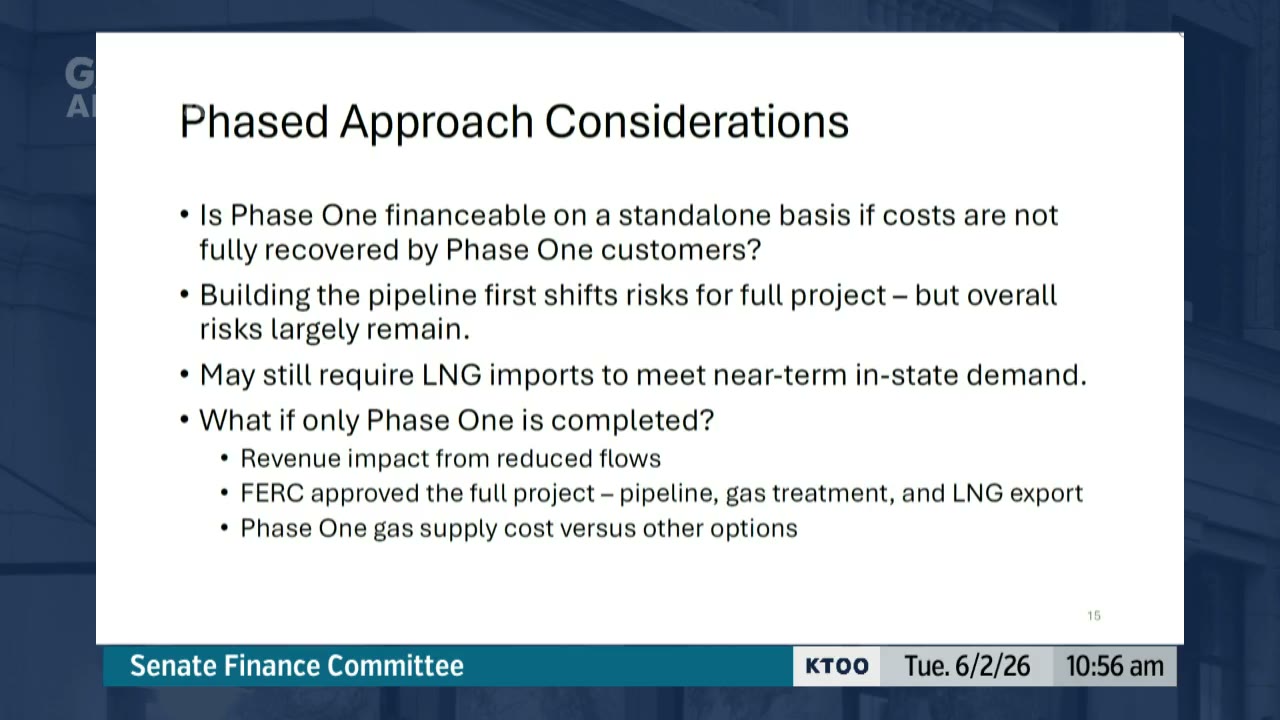

So the questions we identified on this phased approach, is phase one financeable on a standalone basis? If costs are not fully recovered by phase one customers, and that again relates to the economics for the project really being driven by that export capacity,. Building. The pipeline first shifts the risk for the full project, but overall risks largely, largely remain. What we mean by this is that the execution risks to the pipeline are still going to be there.
Independent megaproject consultant warns Alaska Senate Finance that 92% of megaprojects exceed budget or schedule, with LNG projects averaging 70% cost overruns, directly challenging optimistic timelines for the state's proposed gas pipeline and export terminal.
